Blog – the work in the tower

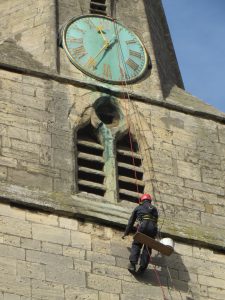

26th April 2017 The Clock Returns

Cumbria Clock installed the new electrical winding mechanism this week and the clock is now work.  Here are photos of Terry Hill of Cumbria Clocks taking the hands off the clock face a few weeks ago.

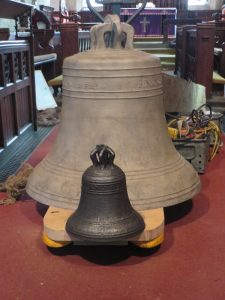

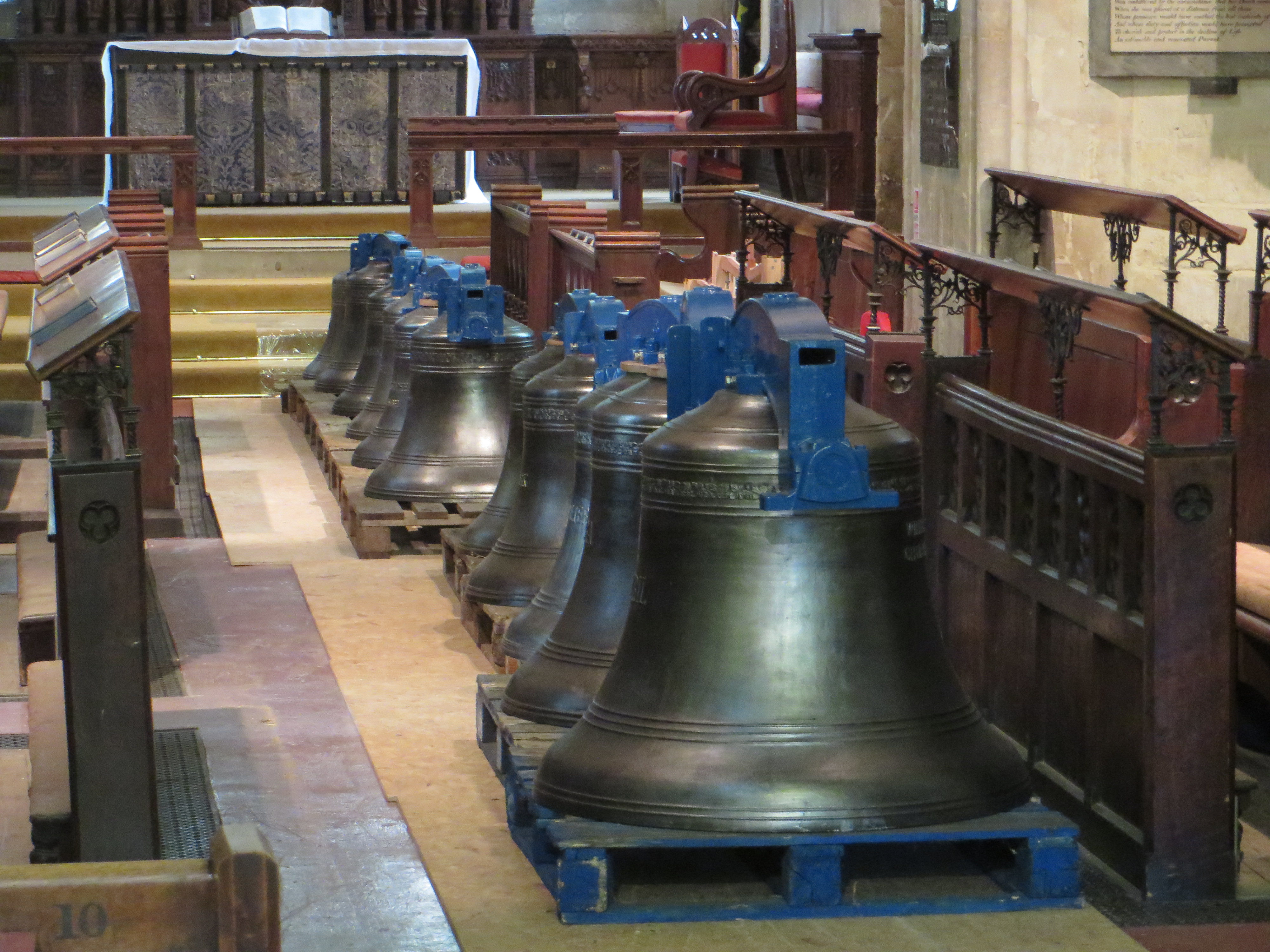

23rd March 2017 The Clock bell and Small bell both returned to the Minster.  The clock bell was winched up into the bell chamber and the small bell was attached to the wall on a metal bracket to keep it safe.

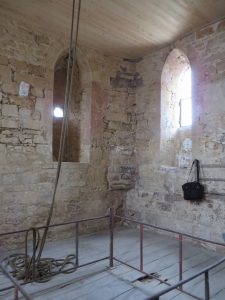

16th March 2017 visited the ringing chamber to see the walls anIMG_2379d marked on the floor where the ropes would fall.

3rd March and 30th March 2017 – remainder of the bells cast.

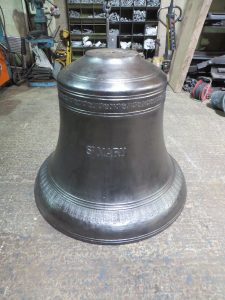

Bell Casting

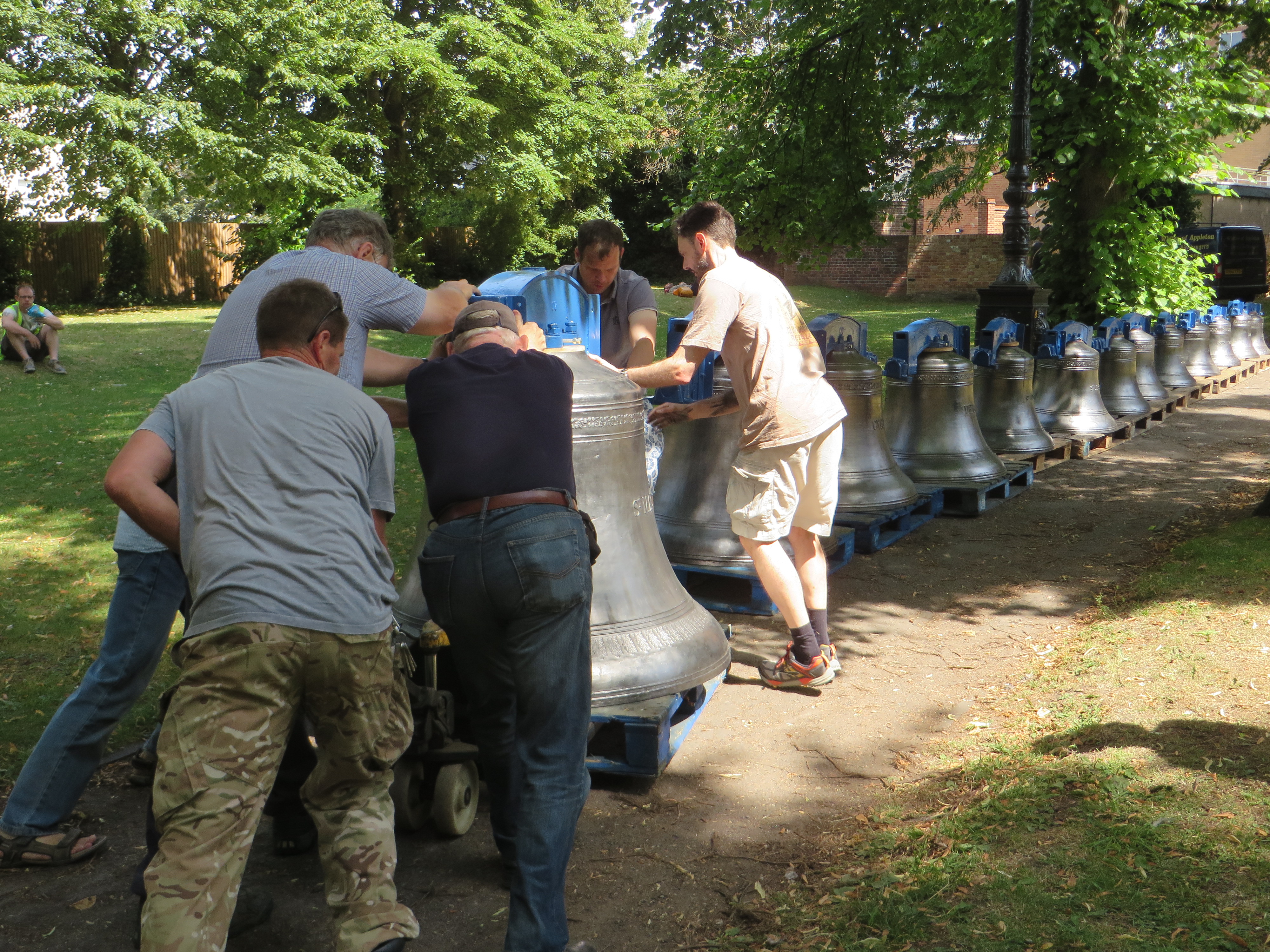

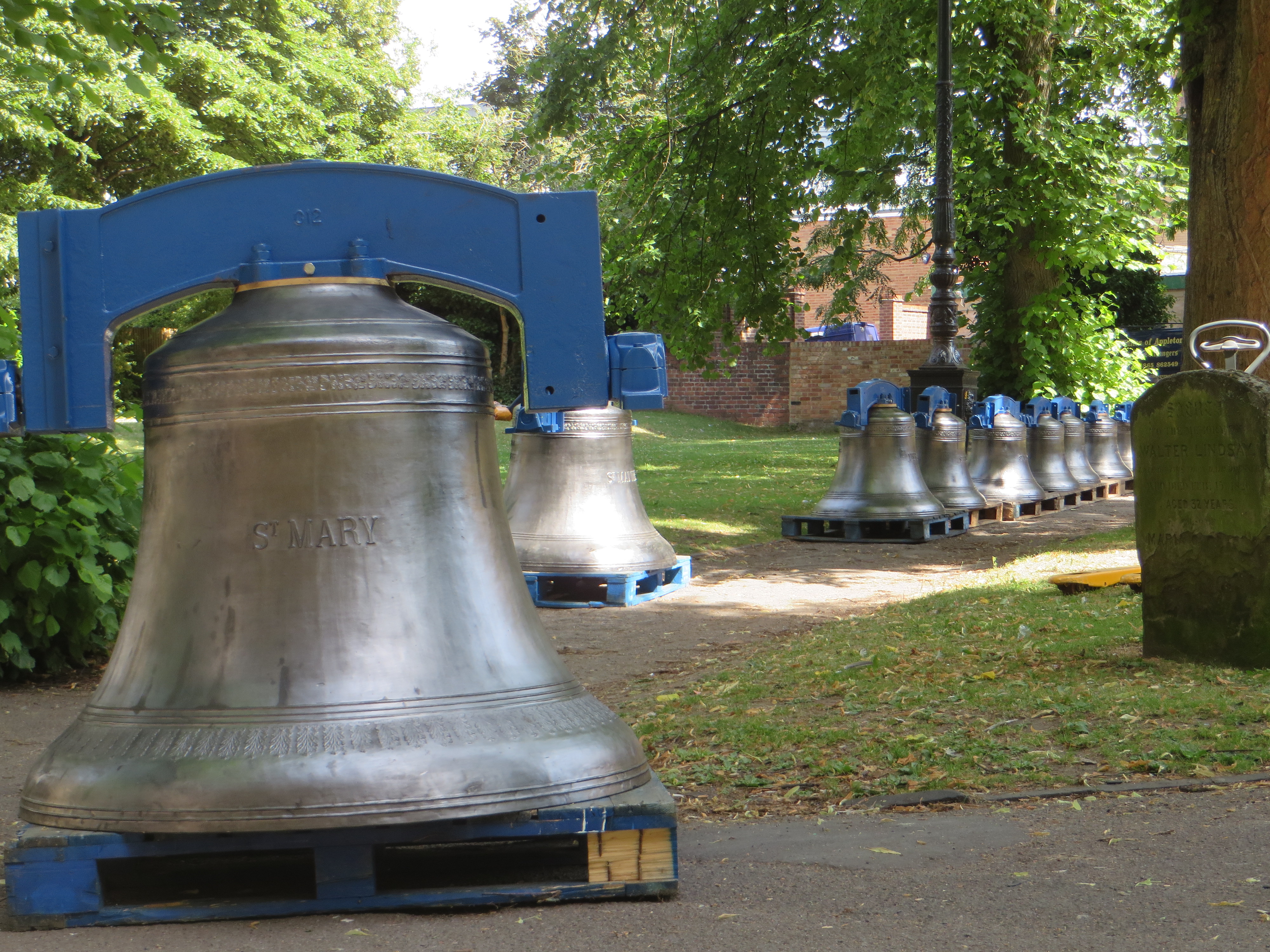

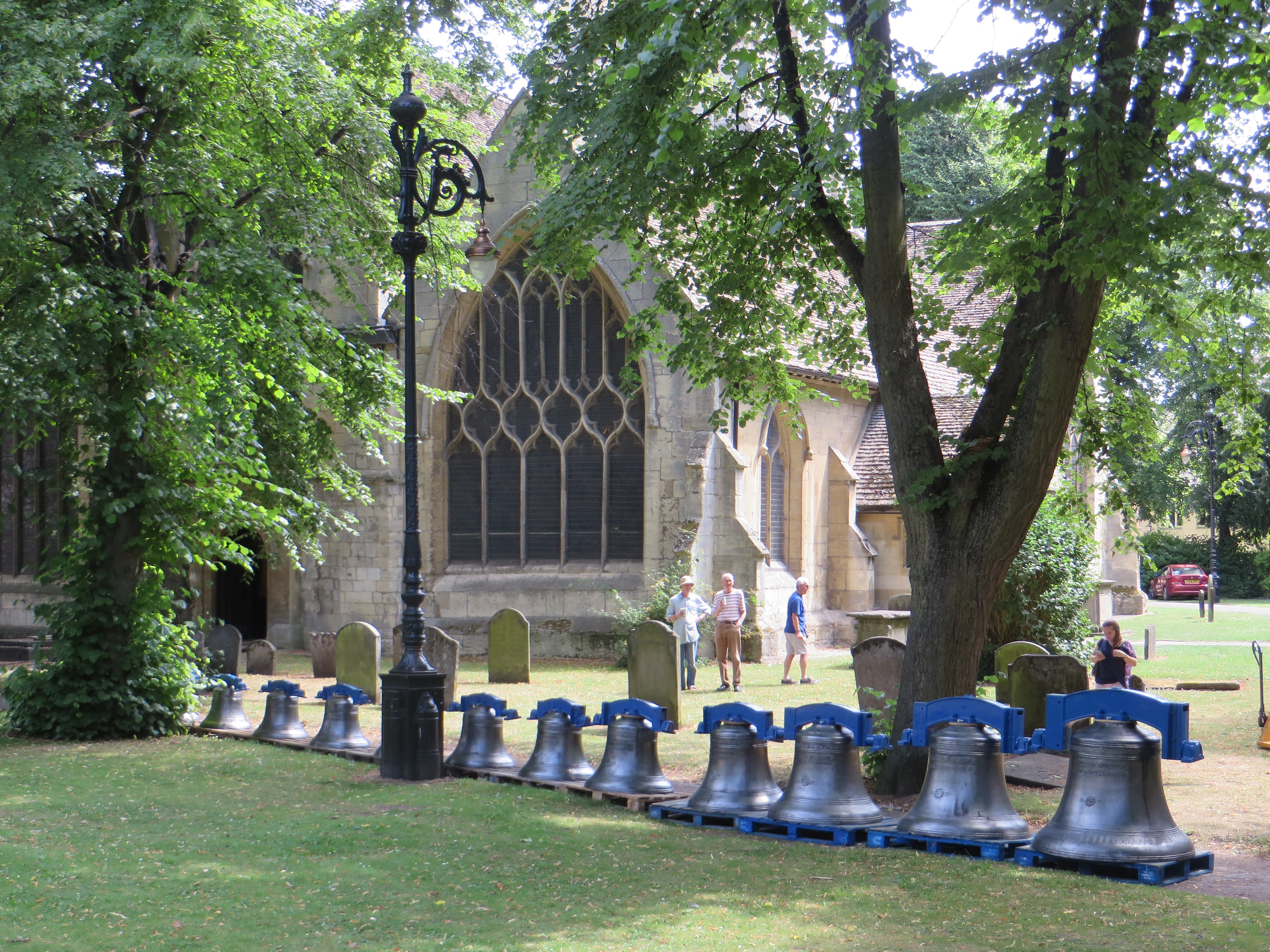

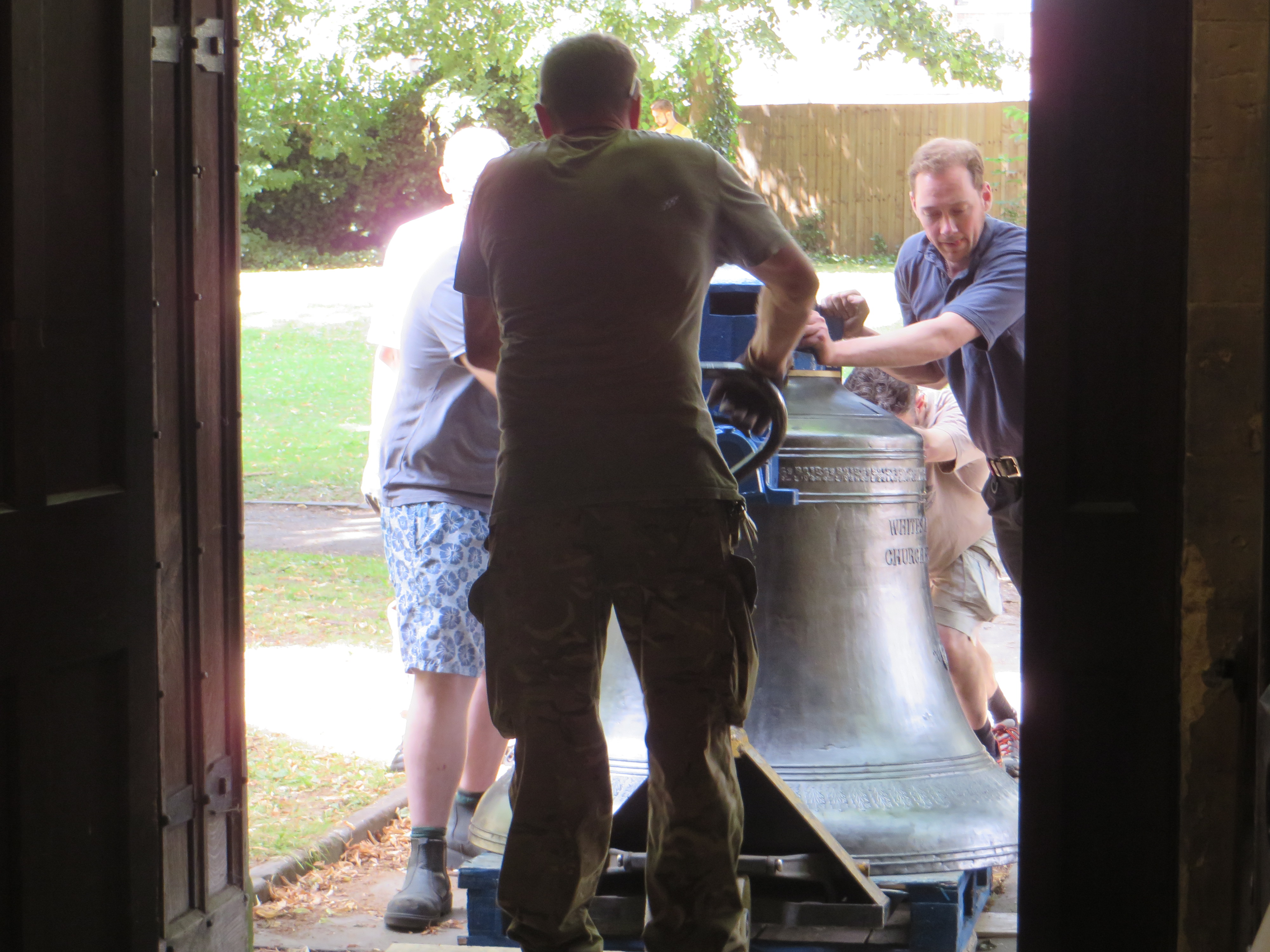

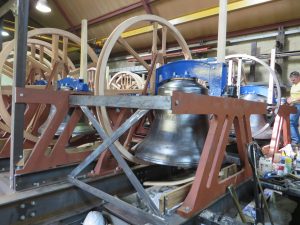

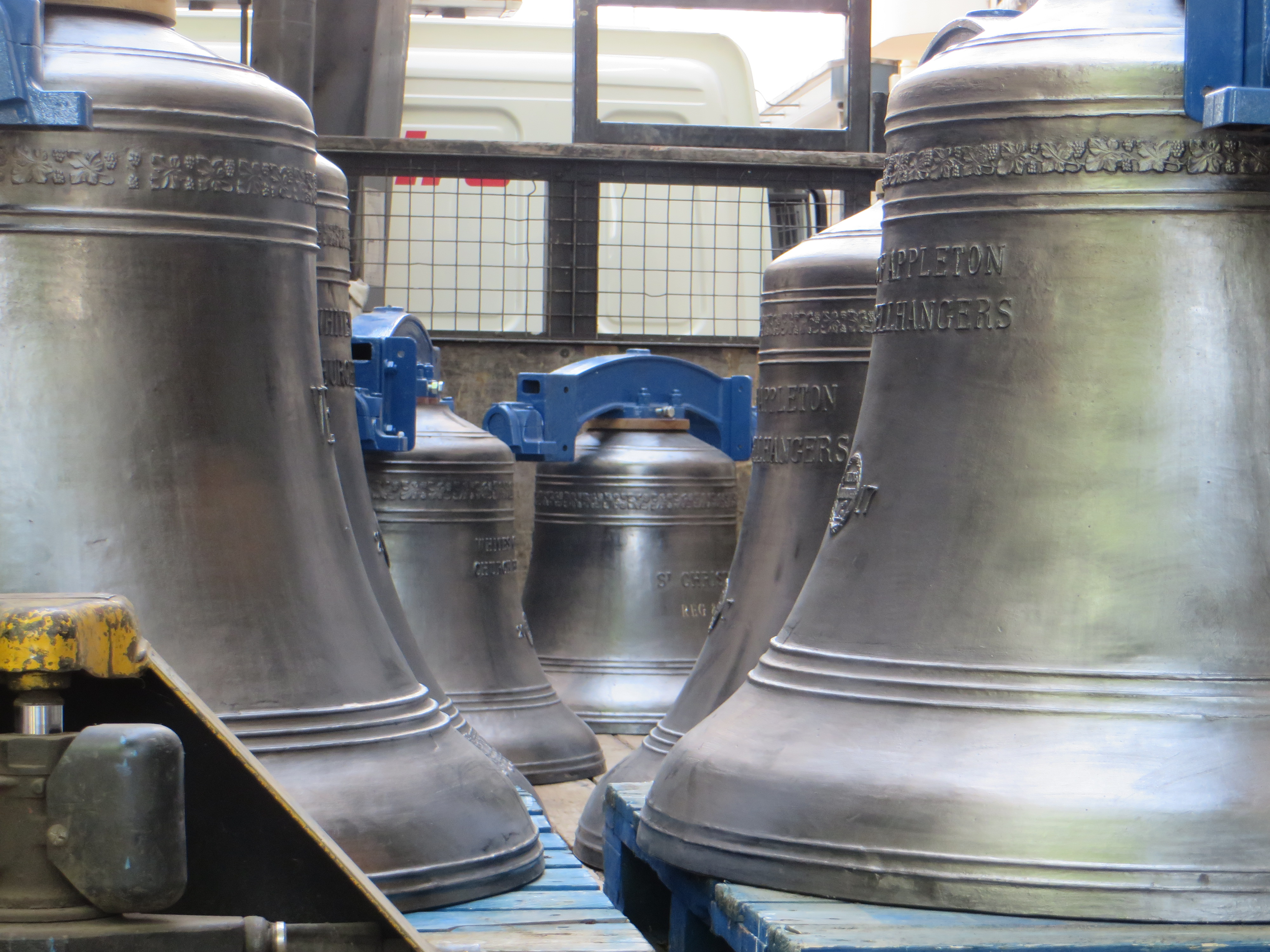

There are four dates for casting and here are pictures taken on 2nd February (with permission of the foundry).

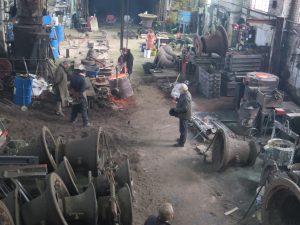

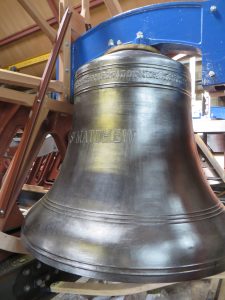

IMG_2054The tower captain, her husband, the rector and his secretary went on the tour of the museum and stayed to watch the casting of two of the bells (2 and #2). Before the bell metal was poured into the moulds, the rector was called down on to the foundry floor and asked to say a prayer.  He said he was very moved to have the workers standing in silence with their heads bowed.

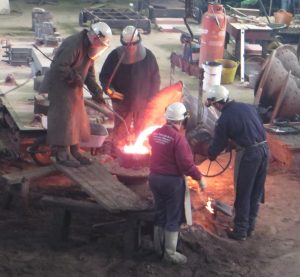

We all found it very exciting watching the moltenIMG_2061 - Copy metal poured into the moulds.  We were kept well away until they had finished pouring.

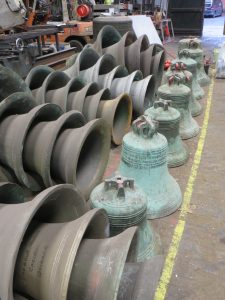

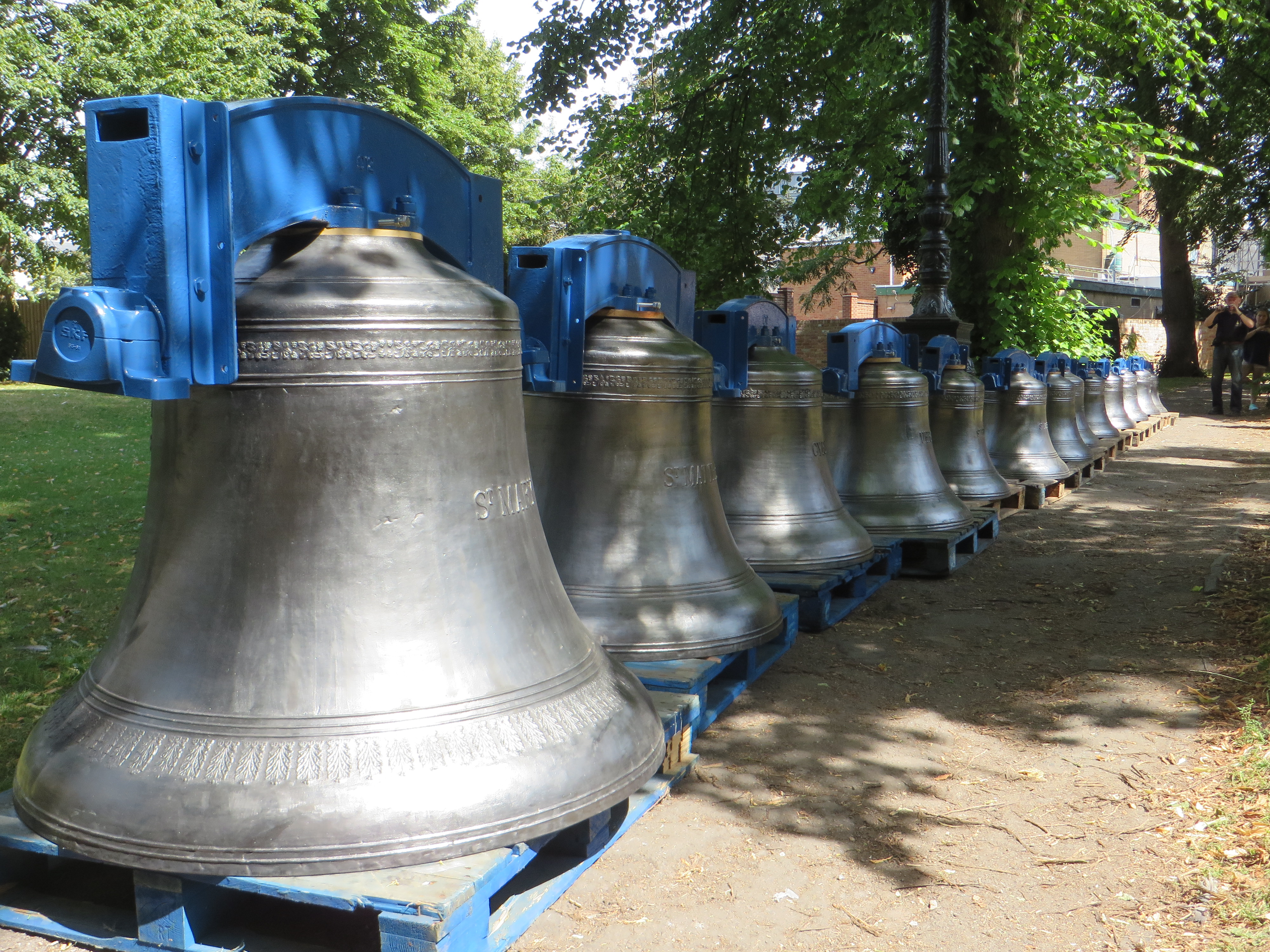

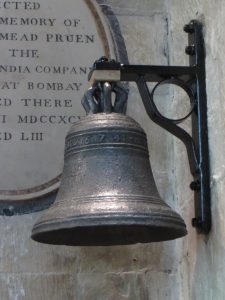

IMG_2011We have sold five of our old bells to two other towers, Butterton and Hawton, through the Keltek Trust.  However, here is a picture of the remaining seven which will be melted down to be recycled.











From week 2 – the builders are in the tower.

Day 4 12th January 2017

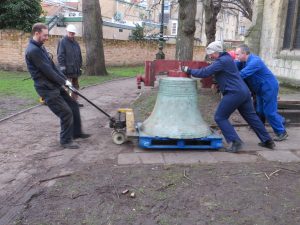

IMG_1936Under James Haseldine’s expert guidance all the bells were transferred out of the church and lined up in front of the porch. When the tenor was being manoeuvred through the door it touched the edge of the doorframe and it was noticed there was a nick in the frame from where the bell entered the church in 1823!

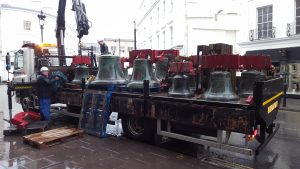

The rain started and James and Graham Clifton of White’s transferred the bells onto the back of the lorry and at about 20170112_12051312.30 we waved goodbye to them. There were still large pieces of frame to be lowered into the church and stacked up ready for the trip to the scrap dealer. The nuts and bolts are being given to the steam railway and some of the pulley blocks and sliders are going to Little Comberton.



Day 3 11th January 2017

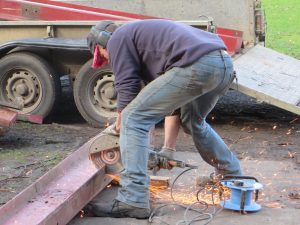

IMG_1903During the day the last two bells were lowered into the church along with a lot of frame. Charles had to cut some of it up to get into his trailer. By the end of the day all the bells were in the church.







Day 2 10th January 2017

IMG_1871Another five bells came down along with various half wheels, clappers, stays, sliders etc. Five of the bells are being sold to other towers so their accoutrements had to be kept with them.











Day 1

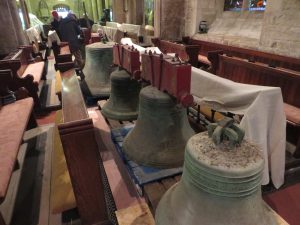

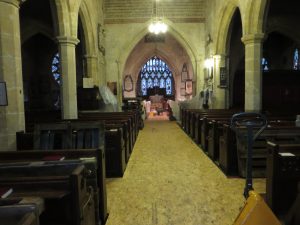

The church floor boarded outOn Monday morning 9th January 2017 the trap door in the roof of the nave was opened.  Two bell hangers and volunteers were up in the tower and during the day six bells (including the clock bell) came though and were lowered slowly to the ground.  More volunteers expertly manoeuvred the bells out of the way into the choir and moved large pieces of frame out of the west door to be taken to the scrap dealer. On Tuesday another five bells were lowered and the last two came down on Wednesday. .

A bell being lowered through the roof of the nave

Reg and James manoeuvre a bell

Reg and James manoeuvre a bell





















The clock bell and four others

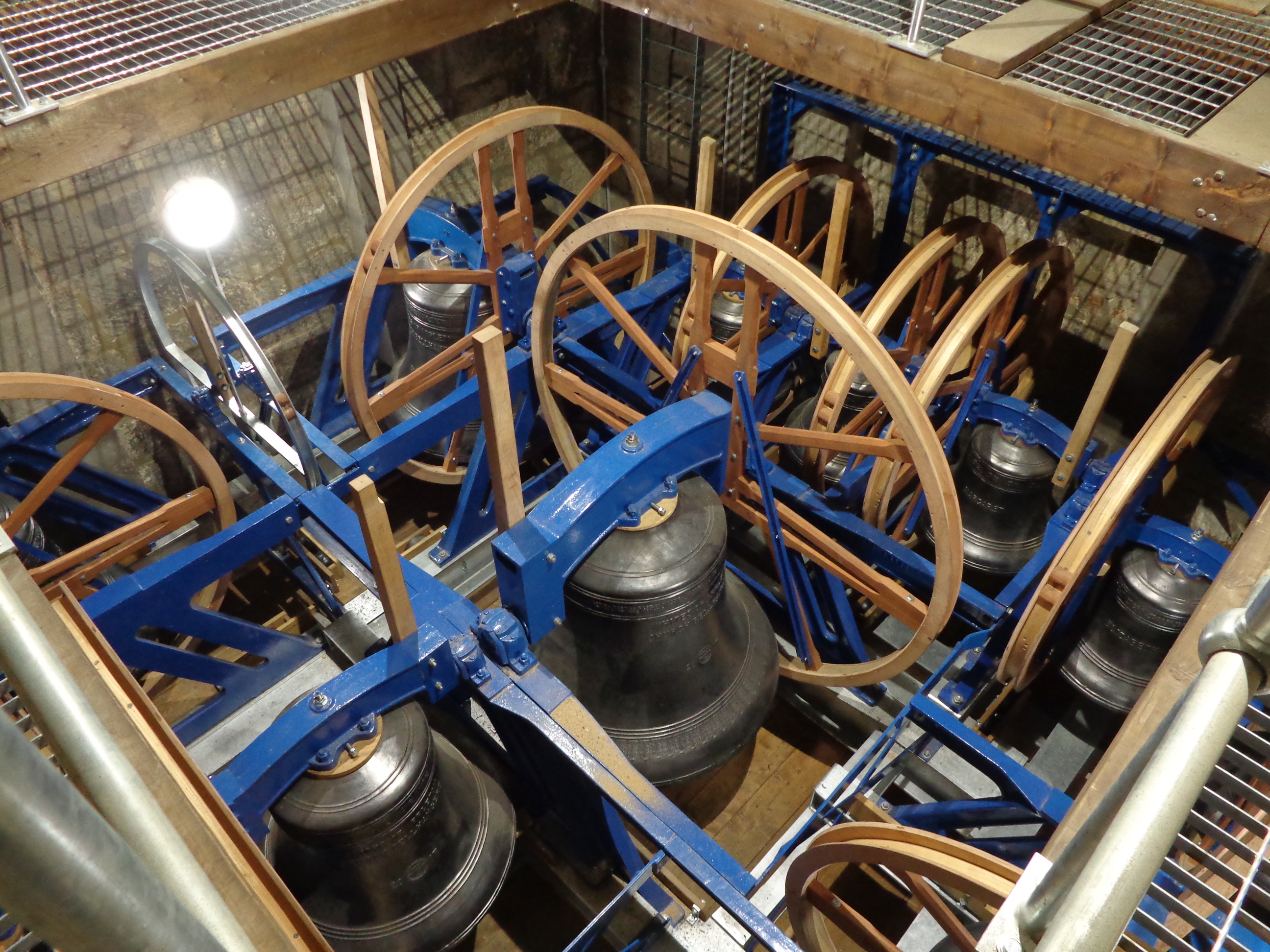

The Bell hangers arrived on Wednesday 4th January 2017 and, with the volunteer labour,  have removed all ropes, wheels, fittings, lifted the tenor and 9th out of their pits,

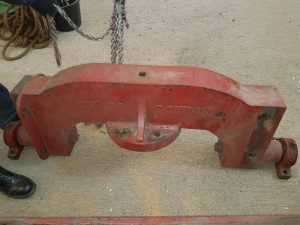

lifted the traps to the ringing room and lowered some components to the ringing room. The Clock bell day-1-4-jan-17has been lowered to the top of the bell frame, all ready to start the main lower on Monday, Tuesday and Wednesday next week.

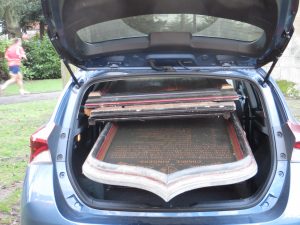

On Wednesday 28th December 2016 five of the bell ringers spent the day in the tower removing peal boards and putting them into storage.

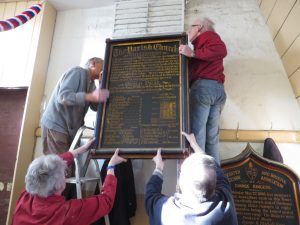

img_1620
